Case study

The soil test that redesigned the foundation

An 11,330-square-foot residence on a raw forest lot in Lutz — no city water, no sewer, no existing infrastructure of any kind. Well, septic, and every system on site sized up to match the scale of the house. The largest home in Nikic’s portfolio by a wide margin, and one where the foundation almost went in wrong.

7,216 sq ft heated · 11,330 sq ft total · 7 bedrooms · 10 bathrooms · 80 piles at 55 ft

A test nobody required

The lot was dense enough with vegetation that a soil boring test couldn’t be done before design started. The original plans were drawn without soil data — no pile foundation included, because nothing indicated one was needed.

Once the site was cleared, Sasa recommended a boring test before the foundation went in. Nothing about the site pointed to a problem. It wasn’t contractually required. He asked for it anyway.

“Most contractors would just keep working with the existing plans. They wouldn’t suggest checking the soil — doing the boring test and making sure the existing foundation can support the weight — which at the end would have cost a lot of money, time, and headache.”

The test found that the first 10 feet of soil was too soft to carry an 11,000-square-foot structure. Engineers calculated that building on the original design would have produced 3 to 4 inches of settlement — enough to crack walls and damage the structure over time. The foundation went back to the drawing board: a full redesign specifying 80 piles, each driven to 55 feet.

Excavated footing trenches for a home's foundation, with vertical rebar dowels and string layout lines running along both sides of a corner, sandy excavated soil piled at the trench edges Overhead view of a steel rebar cage set into an excavated footing trench, with intersecting reinforcement grids and string lines marking the layout above

A two-month problem, solved in the field

The redesign specified 55-foot piles. Standard piles run 30 feet, and 55-foot units carried a two-month procurement lead time that didn’t fit the schedule.

Rather than wait, Nikic sourced 25-foot and 30-foot pile sections and spliced them together on site to reach the full 55-foot depth and load rating.

“We decided to do 25-foot and 30-foot piles and splice them together to give us the 55 feet we needed.”

It’s not a standard workaround. A spliced pile assembly has to be engineered to perform the same as a single monolithic pile at that depth — a field decision that required structural judgment, not just a materials substitution.

A worker uses a walk-behind power trowel to finish a freshly poured concrete slab, with PVC plumbing stub-outs and rebar dowels protruding from the surface and trees lining the property in the background Low concrete block foundation walls outline the footprint of a home under construction, with vertical rebar dowels exposed at wall intersections and the sun setting through trees in the background

A staircase with hidden engineering of its own

The curved staircase at the center of the house required structural work that disappears entirely once the home is finished. The original wall specification wasn’t sturdy enough to carry the load the stair design put on it. Nikic upgraded the wall assembly and added LVL beams to support the cantilevered section of the stair. The stair looks exactly as specified. The engineering that makes it safe is behind the drywall.

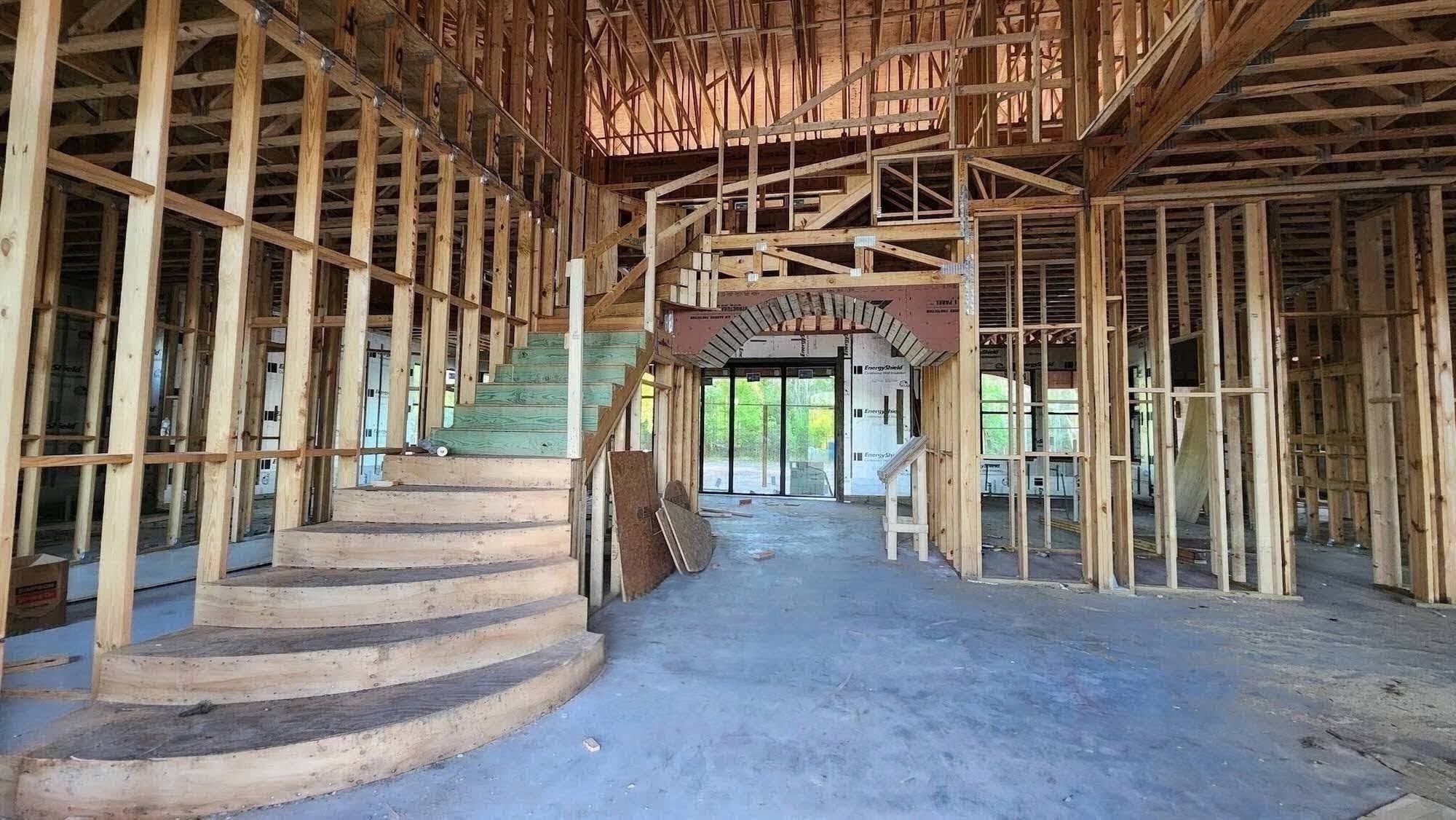

Interior of a framed home under construction showing a curved staircase with green-treated lower steps and natural wood upper steps, rising beneath a tall vaulted ceiling of exposed roof trusses, with an arched wood-framed opening leading to sliding glass doors at the rear

Still being finished

The house is in its pre-final stage — the shell, roof, and structure are complete, but finish work is still underway. The photos below show that progress: first-floor block complete with wood framing rising above it, and the finished tile roof over walls still wrapped in sheathing, waiting on their final exterior finish. A full portfolio walkthrough will follow once the home is complete.

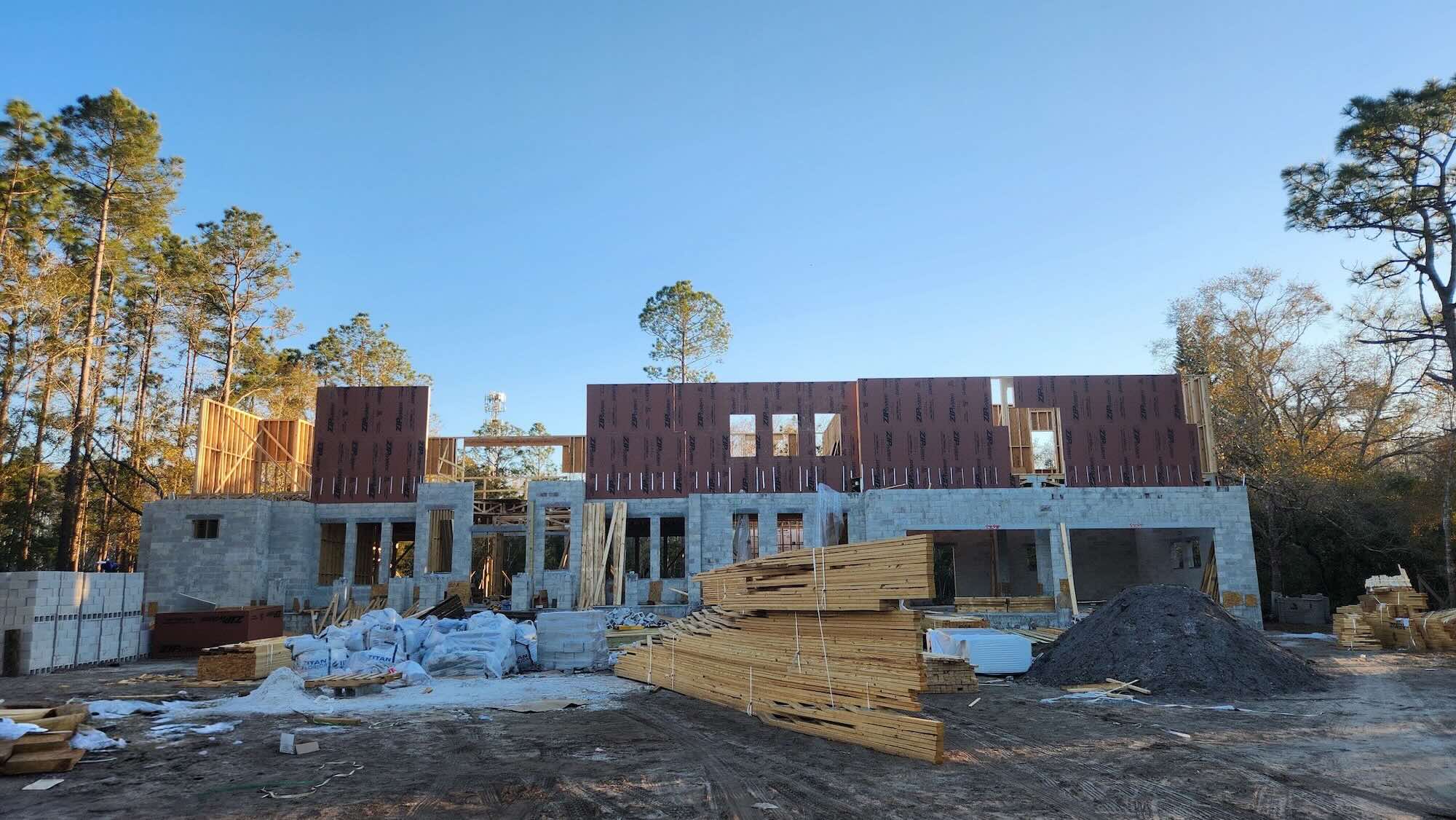

Two-story structure under construction at dusk, with finished concrete block walls on the first floor and wood-framed second-floor walls wrapped in ZIP System sheathing above, surrounded by stacked lumber and building materials Two-story home under construction with a completed dark tile roof, ZIP System sheathing on the upper-floor exterior walls awaiting cladding, arched window and door openings in the concrete block lower level, and a rental dumpster in the front yard

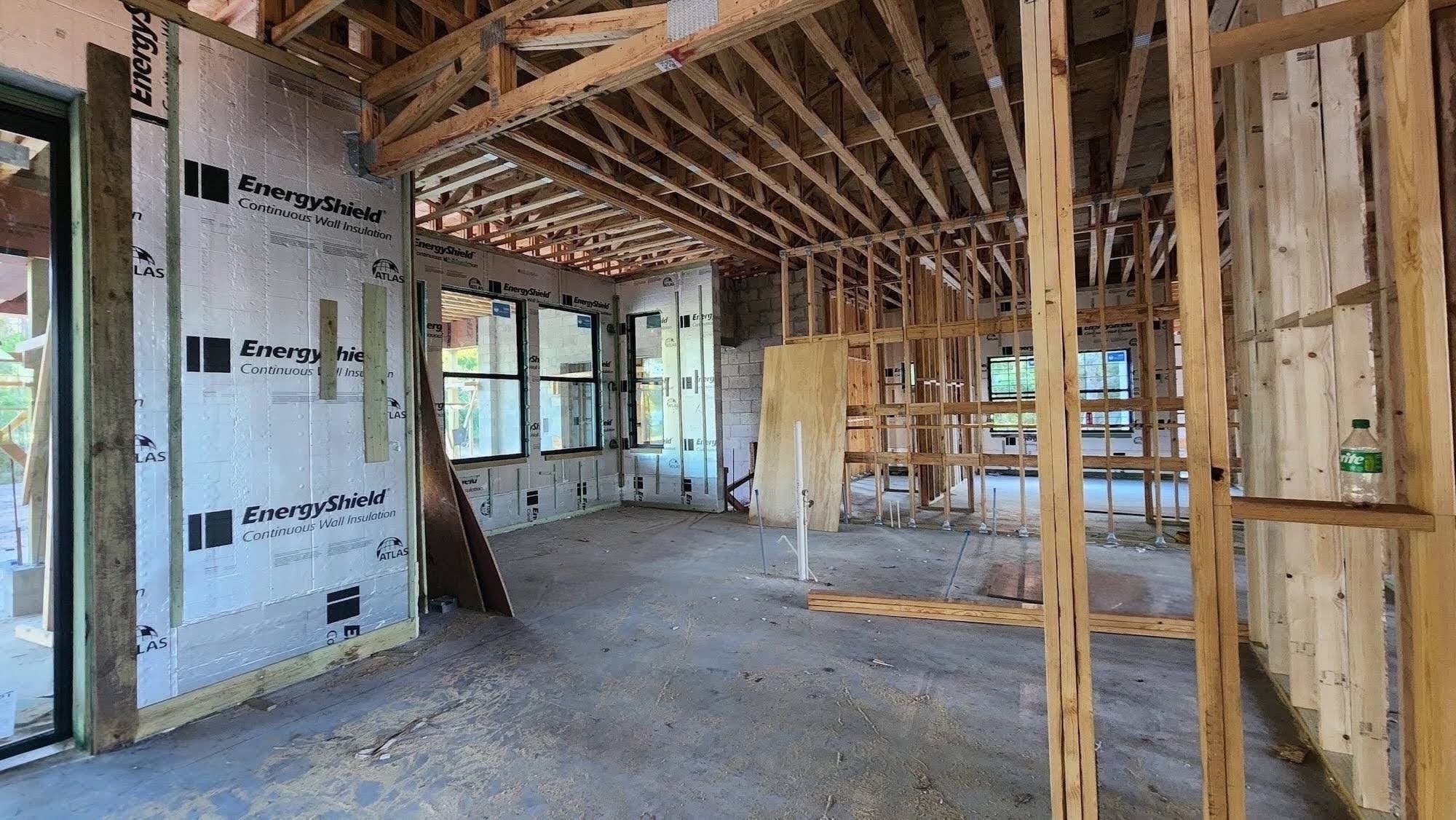

Framed interior room with EnergyShield continuous wall insulation panels installed on the concrete block walls, exposed roof framing overhead, and window openings looking out to the surrounding lot

A redesign of real scope, not a stalled project

A scope change of that size — an unplanned foundation redesign adding 80 piles, mid-project — is the kind of thing that can derail a build. This one didn’t: construction continued through it, and the house has since progressed through framing, roofing, and rough-in. The photos throughout this page are from that continued work — the home is not yet finished, but the redesign itself never stopped it.

Sasa’s own read on what he’d do differently next time isn’t about the piles or the splice — it’s about the test that started it.

“It’s better to do it the first time and design only once.”
